All temporary water services for the first phase of the project have been swapped over to the new permanent ductile iron water mains. There are no further scheduled water disruptions for the project until spring.
The following activities are planned for the week of Monday, Nov. 10:
Drainage work
On Monday and Tuesday, November 10 and 11, project contractor S.U.R. Construction, Inc., plans to excavate a section of Court Street just north (toward downtown) of the Union Street intersection to install a large drainage maintenance hole. This work will require Court Street to be closed. S.U.R. will also complete remaining storm drainage work on this section of Court Street between Union Street and Central Avenue.
Once the Court Street drainage work is complete, S.U.R. intends to continue drainage infrastructure work on Union Street, starting at Court Street and working towards Central Avenue.
Court Street road work Wednesday-Friday
On Wednesday, Nov. 12, S.U.R. plans to mobilize an additional crew to remove all remaining asphalt pavement on Court Street between Union Street and Central Avenue to prepare for the new road subgrade and pavement.
On Thursday, Nov. 13, S.U.R. anticipates “boxing out” this section of Court Street, starting from Central Avenue and working south towards Union Street. By “boxing out,” S.U.R. will be excavating the entire road section down to a depth of about 20 inches, which will then be filled with structural gravel material to develop the road subgrade, which will then be ready for new asphalt pavement.
The boxing out will occur on one side of Court Street at a time. S.U.R. will work a full day on one side excavating and adding gravel materials to the required grade. On Friday, Nov. 14, S.U.R. will repeat the operation on the other half of the road, starting again at Central Avenue and working toward Union Street.
Residents should expect delays entering/exiting homes
Residents should be prepared for delays getting in and out of driveways when during the excavation work as well as an increase in of truck traffic. Residents are encouraged to make provisions, such as allowing ample travel time or parking vehicles outside of the construction area.
Base paving to occur before Thanksgiving
The entire road will be a gravel surface for several weeks with the base layer of asphalt pavement anticipated to be laid down on Court Street between Union Street and Central Avenue by Thanksgiving, Thursday, Nov. 27.
The following traffic and parking restrictions will be in place on weekdays from 7 a.m. to 5 p.m. once the project begins through approximately December 2025.
The contractor will accommodate local traffic getting to and from their destinations in the work zone. They will also post NO PARKING signs in the restricted areas.
Notify city of bulky item trash to ensure its picked up
City staff encourages residents in the construction zone who have bulky item waste (and have purchased bulky item tags) to call Community Services at 603-516-6450 before Tuesday's regular trash pickup. This helps the city coordinate with Waste Management and ongoing construction activities and ensure the items are picked up.
Questions/Concerns?
Residents who have concerns about how construction may affect their property are encouraged to contact the Community Services Engineering Department to schedule an onsite meeting.
For non-owner-occupied properties, the city recommends property owners to encourage their tenants to sign up for project email updates.
Sign up for project email updates by visiting https://bit.ly/dovernewsletters and adding “Project update: Court Street and Union Street Reconstruction” to your current email subscription list.
Thank you to all those who attended the Aug. 14, 2025 neighborhood. For those who were unable to attend, a recording of the meeting and the presentation materials are available on the project website.
The contractor may need to temporarily step onto private property outside the public right-of-way to properly connect the limits of the project to private property and ensure positive drainage. City staff have mailed Right of Entry letters to property owners abutting the project detailing what to expect.

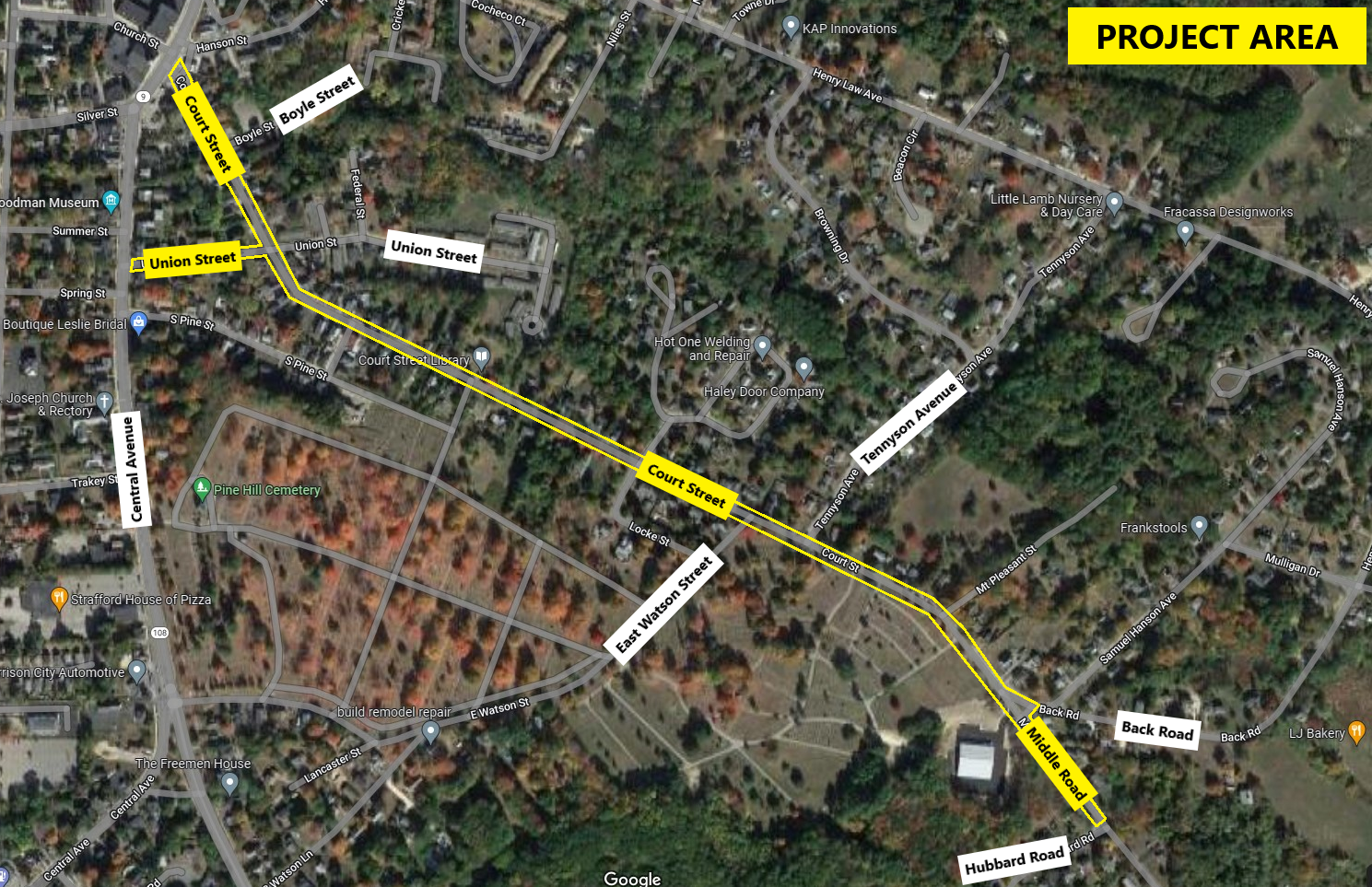

The project limits include Union Street, from Central Avenue to Court Street, and Court Street from Central Avenue through Middle Road to just east of Hubbard Road. Following feedback through neighborhood meetings, emails and survey, the final plans incorporate a combination of the two initial concept plans presented to the public. The plans utilize shared use lanes and bike lanes depending on the section of the project.
The City of Dover has targeted Court Street and Union Street for street reconstruction to upgrade underground utilities and address drainage concerns and roadway/sidewalk conditions. The city has been planning for the project through six-year Capital Improvements Program the City Council adopts each fall.
The reconstruction project will follow the City of Dover's Complete Streets and Traffic Calming Guidelines, including extending Court Street's sidewalk from South Pine Street to Hubbard Road. Engineers will also evaluate the intersection of Back Road/Court Street/Middle Road to identify opportunities to increase motorists, bicyclists, and pedestrians' safety.
Survey work began in Summer 2021 and has included geotechnical borings to investigate subsurface conditions within the project area, video inspection of the existing stormwater drain, sewer main and sewer services and creating a base survey. The goal is to have engineer design plans developed through the year with construction to begin in 2023.
As the project develops, the City of Dover plans regular email updates to help residents and business plans for the construction disruption. To sign-up for these updates, visit https://bit.ly/dovernewsletters, add “Project update: Court Street and Union Street Reconstruction” to your current email subscription list.
